William Pake’s Eagle Project
Shady Grove Presbyterian Church Frontier Lot Stairway Replacement Project
SATURDAYS — October 24th, 31st, November 7th, 14th
We’re looking for a little help each Saturday.
About The Project
Project Background

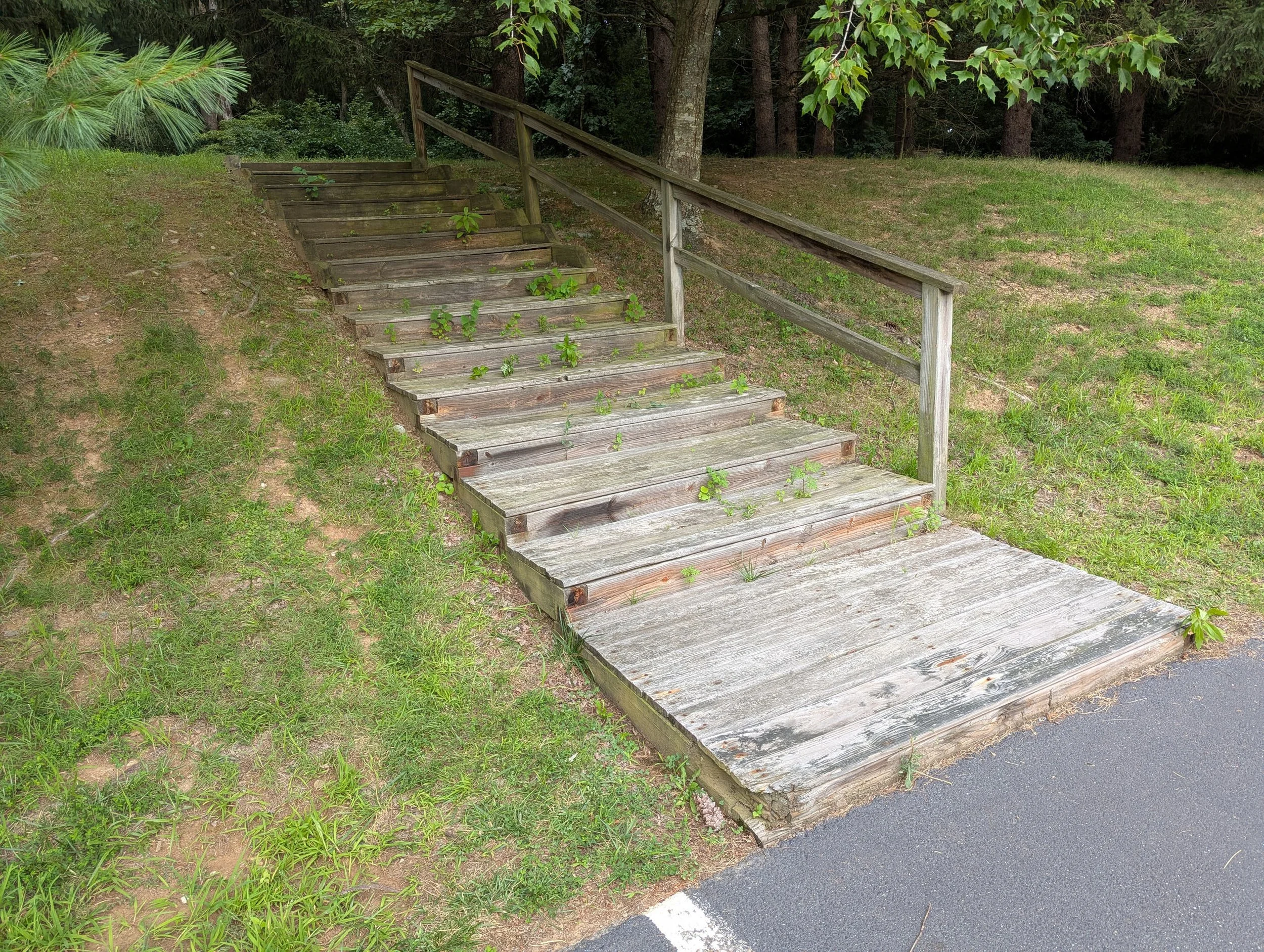

This wooden stairway connects the back parking lot of Shady Grove Presbyterian Church to an overflow parking area. However, the stairway is quite old, a number of the step boards have rotted out, and underlying support for the steps have either rotted as well or have eroded and washed away over time, causing many of the steps to either sag when stepped on, or bow upwards. The stairway has become unsafe, and so my Eagle project is to completely replace the entire stairway with a new and improved design, which should hopefully be a little more robust and durable.
The overflow parking area behind this stairway is quite important to the church, and is used semi-frequently for special events, weddings, large holiday services, and other events where a larger than normal amount of traffic might be at the church. Thus, it’s important for this stairway to remain usable and safe for church attendees.
New and Improved Design
Several rebuild options were presented to SGPCA, and the church opted for a full replacement of the stairway.
The current stairway is framed with 4×6 lumber, and then 1×6 step pieces (aka 5/4”x6 for 1” actual thickness), with one narrower 1×1 or 1×2 step board per frame. The railing pieces are 4×4 posts, with 2×4 connecting beams. (The railing is not formally part of the Eagle project, but will be replaced in parallel to it.) The weak point of the current design is only “soft” support underneath the 1×6 step boards (either dirt or gravel) that washed away or eroded over time, allowing step boards to both sag downwards and bow upwards. This has creating numerous tripping and falling hazards for anyone on the stairs, and so the stairway has no longer really been safe.
The new design will use more heavy duty 6×6 frame sections, up from 4×6, and similarly sized 1x6 step boards. The big addition to the design are two 2×6 joist sections per frame to screw the 1×6 step boards to. This will not only prevent sagging of the steps, but will prevent them from bowing upwards as well, and should overall be more durable over time. In addition to the standard pressure treated lumber’s weather protection, the 1×6 and railing pieces will be coated with Thompson Water Seal Clear for an extra layer of protection.

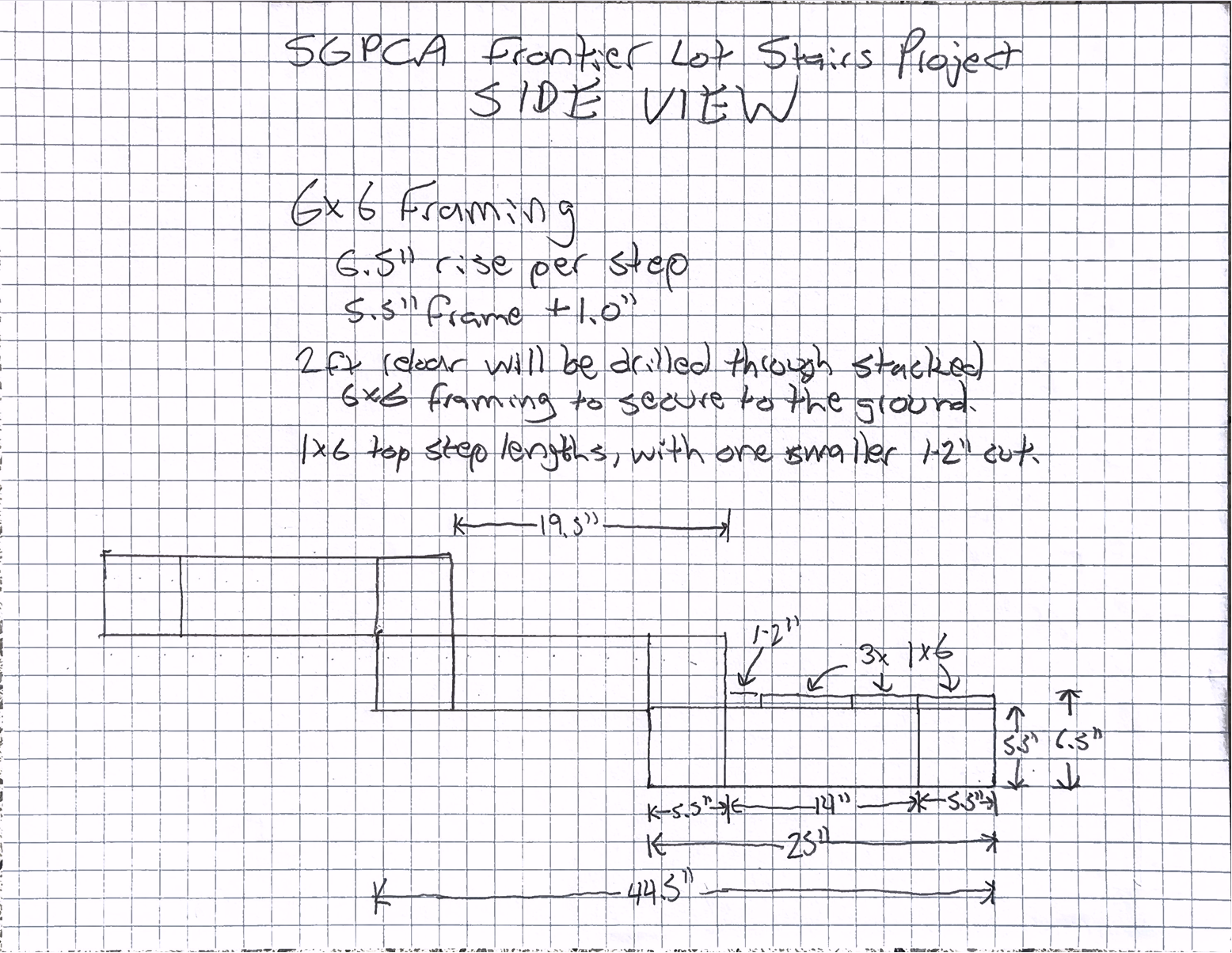

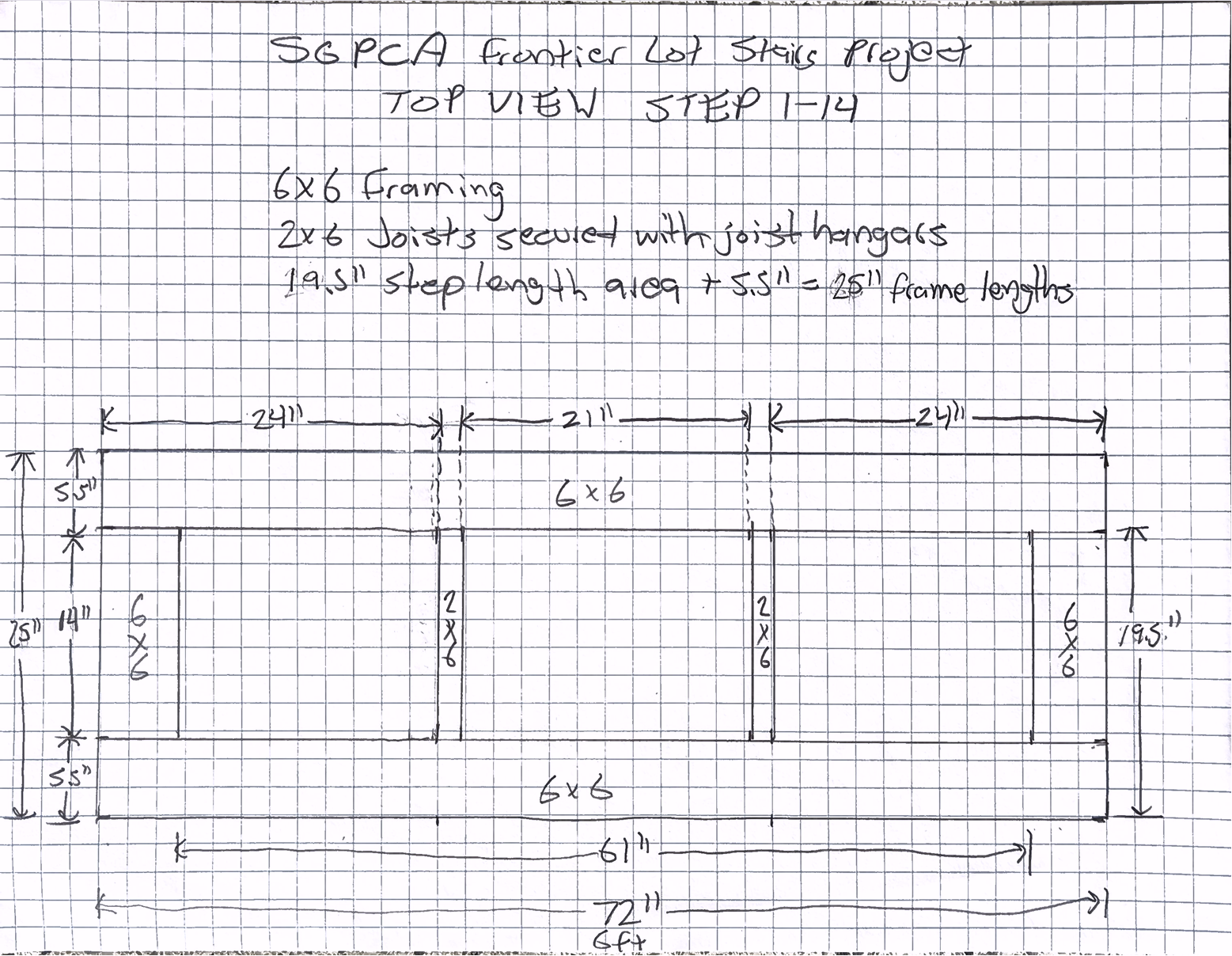

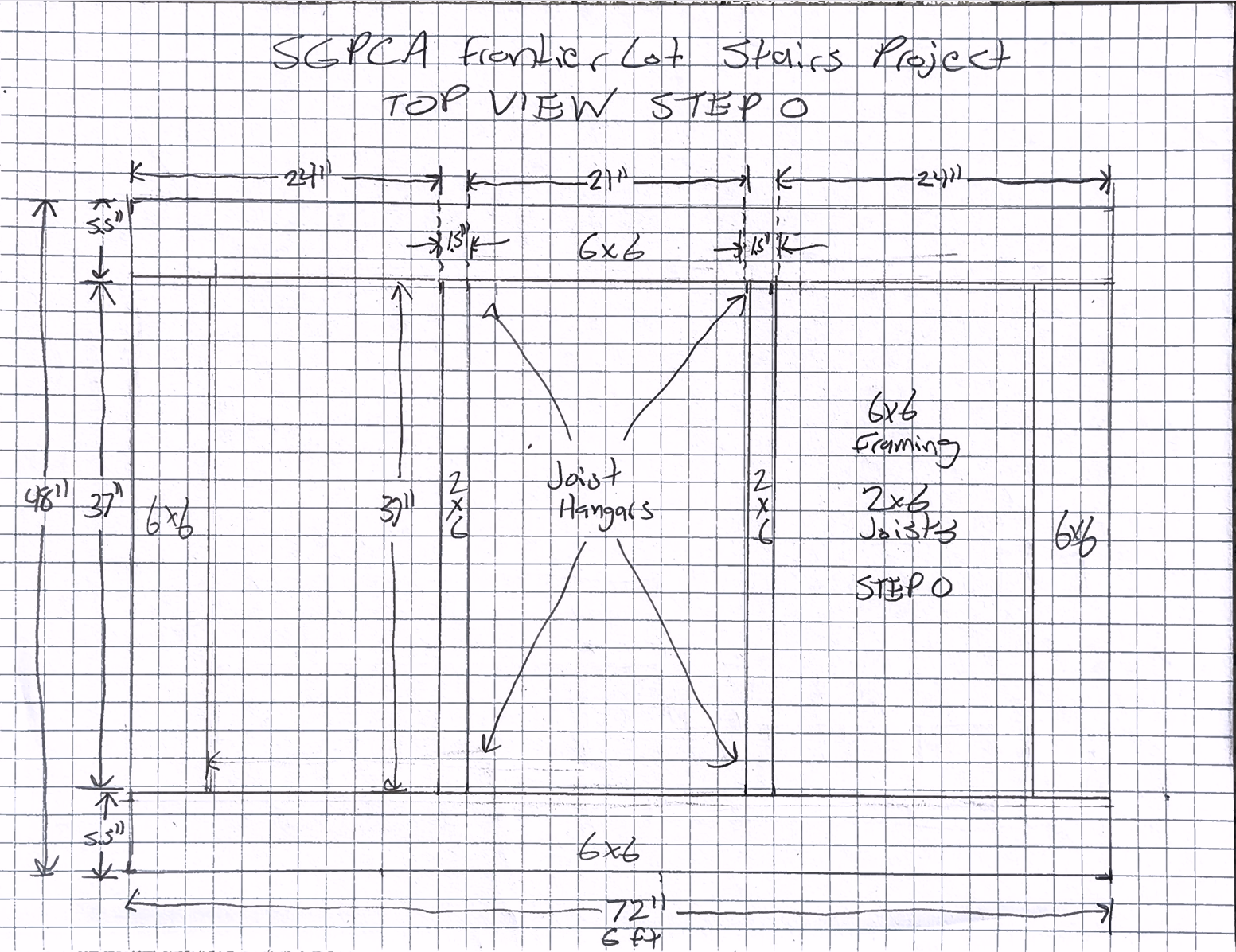

Engineering Drawings

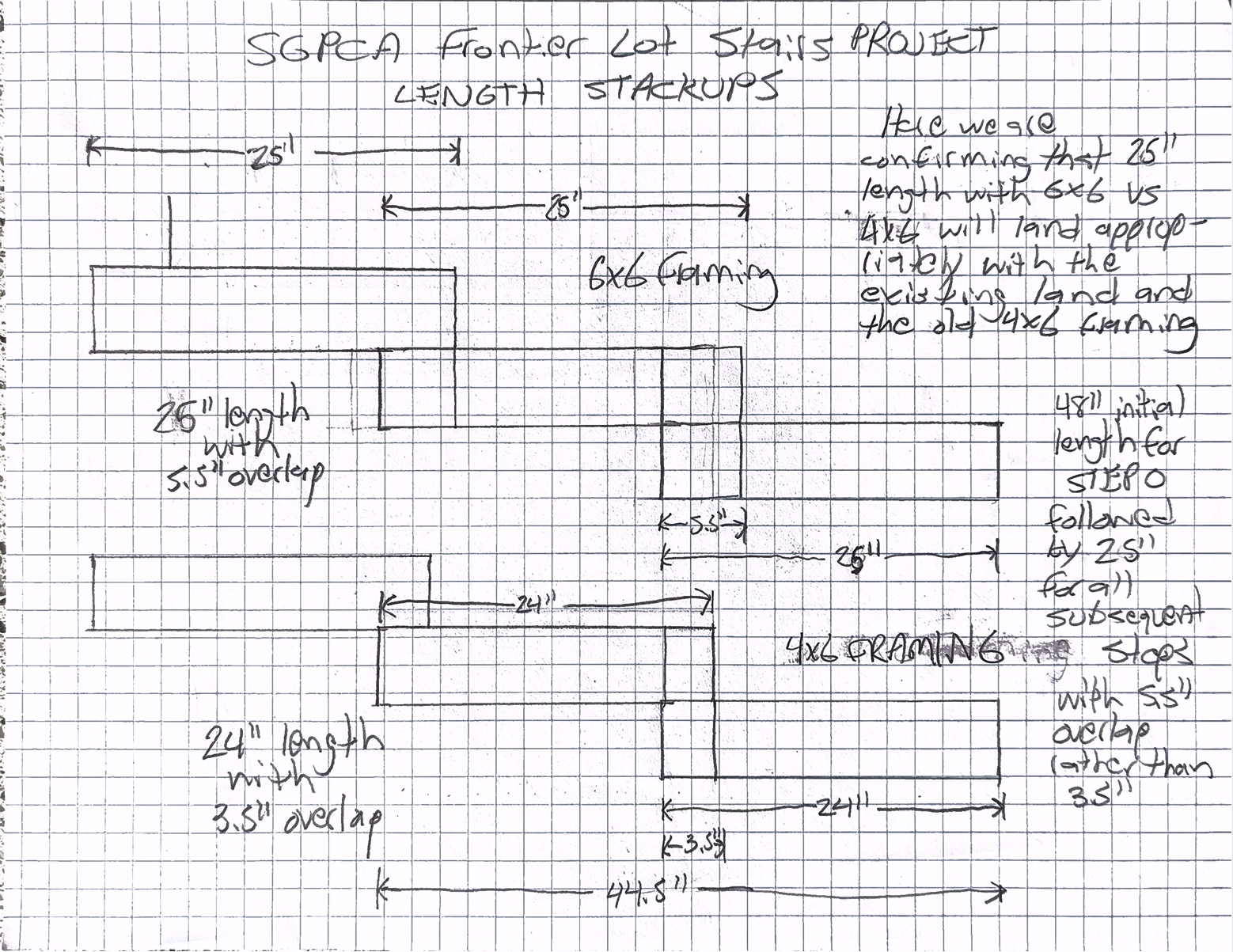

Certain dimensions needed to be slightly altered with the new design to account for the 6×6 framing vs 4×6 in order to maintain the same ground contact profile, and even overlap of the framing for securing to the ground.
Mock Up
(If you’re really sharp or you have some amazing autist/ADHD powers,
you might be able to notice that we deviated from our paper design slightly. Can you spot where?)
Project Schedule and Workflow
Saturday, October 24th (@SGPCA)
We're going to be decommissioning the old stairway this Saturday, and using a lot of hand tools such as crow bars and pry bars, wrenches, hammers, shovels, and wheel barrows. Adults will be using a sawzall and possibly a chainsaw. We will also be moving the underlying gravel into wheel barrows. Both scrap lumber and the gravel will be transported a short distance away into a designated area. Old rebar that had anchored the previous stairway into the ground will also either need to be removed, or hammered the rest of the way into the ground.
Sunday, November 1st, 1-4pm (@Pake Household)
On October 31st, we will be taking the 6×6 cuts of lumber, and assembling them into new 72×25” frame pieces for the new stairway with 10” lag bolts. Power drills will be used for this. After the frame sections have been assembled, two 2×6 cuts of lumber will be installed as joists and onto joist hangars within each frame piece. These joists will provide additional support for the top step planks and prevent future sagging and bowing.
Friday, November 6th 6:30 - 8:30pm
We will be transporting all of the materials from our home to the church parking lot via trailer, and could use some help.
Saturday, November 7th, 11-7pm (@SGPCA, rain date Sunday afternoon, 1-7pm)
FINAL BOSS DAY. We will be installing the new stair frames onto the hillside today. It’s expected that some additional ground leveling and/or clearencing may be needed for both frame and joist clearance on each landing. A special “leveling jig” has been created that should greatly ease and accelerate this process! After placing each subsequent frame into position and checking the final level, an adult will use a high-powered drill with a long auger bit to drill a half inch hole through the two stacked 6×6 framing pieces. Scouts will then hammer rebar through the 6×6 frames and into the ground with special drilling hammers, to secure the stairway to the ground.
After enough new frames have been installed, a second crew can begin installing 1×6×6 step boards onto the lower frames. Typically, each step frame will require three 1×6 pieces of 6-feet lumber except the bottom most frame. These will be secured to the frame with 12x T25 deck screws per board and power drills. Careful attention will be needed to ensure the steps are installed evenly and level, and that the better side of each piece is facing up for aesthetic purposes. Pieces that are very knotted or that have split ends should not be used. These will be used for the final “rip cut” step board on each frame, which can vary in its needed with from between 1-2” depending on how each frame lands on top of the next. The 1×6 boards that aren’t as good will be used for these cuts.
We hope to have most if not all of the step frames installed on this day, along with most if not all of the 1×6 step boards.
We are planning to work as late as 7pm if necessary, and will have site lighting setup. It will be high glare, so if you’re glare sensitive you might want to bring a hat to help shield your eyes. Please bring charged camping headlights, and preferably wear high-top hiking boots for best ankle support while working on an incline.
Saturday, November 14th, 11-7pm (@SGPCA, rain date Sunday afternoon, 1-7pm)
JUST FINISHING TOUCHES (hopefully) We will start by installing any remaining step frames and 1×6 step boards, although we hope to have had most of this completed the previous Saturday so that we can focus on finishing touches. The final 1-2” wide “rip-cut” step boards will be installed on this day, along with the angled side trim pieces. It’s expected that some sanding is going to be required as well. And although it’s not formally part of the Eagle project requirements, Mr. Pake will be working on installing the new rail posts and railing in parallel to this, and could use some help with this as well.
Project Safety and Facilities Information
SAFETY
Closed toe shoes and socks REQUIRED. No crocs, flip-flops, or sandals. We will be working on an incline, so hiking boots or trail shoes are highly recommended for best support and to avoid slipping.
Works gloves REQUIRED. We will be handling wood with nails and screws protruding, and also moving heavy materials. You’ll need to keep your hands protected at all times. Please bring your own work gloves. We will have some extras on hand.
Long pants STRONGLY RECOMMENDED. Long pants will serve as a layer of protection against a glancing blow from a nail, screw, or other sharp object. Plus it won’t really be warm enough for shorts anyways! :)
Safety glasses OPTIONAL but recommended, only for the tear down day, October 24th. We will have some safety glasses available.
Site hazards include but are not limited to half-inch rebar stakes which we will be cutting around, exposing, and removing, along with all of the step boards which will have nails and screws still attached. Thus, proper footware and gloves MUST be worn at all times.
MATERIALS HANDLING
We will be removing the old lumber with pry bars, and the screws and nails will still be attached. You should always assume there are nails or screws on the other side of any lumber you are about to pick up. Use great care when handling this material, grab gently from the sides first to flip the material over and inspect where you can firmly grip the material before moving it. Always assume a hidden screw or nail is on the other side of whatever you’re going to pick up. DO NOT just grab the material blindly from the ends without inspecting the opposite side first.
During the pre-fabrication and construction phases, gloves will also be required as lumber can have uneven cuts and unexpectedly sharp areas and edges.
FACILITIES ACCESS
Leave no trace! We will have bathroom access within the church on the work Saturday’s. However, please remove shoes before entering, and take great care to avoid tracking in dirt, mud, or leaves. The church will have been cleaned and prepared for Sunday services, and we would like to keep it spotless.
